Tuesday, 17 November 2026

Neutron rocket delay explained: voids in carbon tanks force fix

Tiny air pockets in a carbon fiber tank dome pushed Rocket Lab’s Neutron to 2027, even as customers book flights and the Pentagon offers a loan.

Carbon composite rocket tank dome in cleanroom with gloved hands inspecting it

The short version

  • Rocket Lab says Neutron, its new reusable medium-lift rocket, will not make its first launch until 2027.
  • Inspections found voids, or air pockets, between carbon fiber layers in a newly cured forward dome of a first-stage propellant tank.
  • The flaw formed in thicker sections added after an earlier tank failure; a dome built with a revised process has since passed inspection.
  • Demand keeps growing anyway: 16 Neutron missions are booked, the base price rose to $70 million, and the Pentagon offered a $150 million conditional loan.
Quick read · 2 min

Rocket Lab’s Neutron rocket won’t make its first launch until 2027. Inspectors found voids, tiny air pockets between carbon fiber layers, in a newly cured dome at the end of one of the booster’s fuel tanks.

The flaw came from thicker carbon sections added to strengthen the tank after an earlier tank burst in a pressure test. Rocket Lab changed its process again, a new dome passed inspection, and the faulty forward dome was replaced. The booster is too big for a standard curing oven, which makes these parts unusually hard to build.

  • 16 Neutron missions are already booked.
  • The base launch price rose from $55 million to $70 million.
  • The Pentagon offered a $150 million conditional loan to help Neutron fly more often.

Next up: tank and engine qualification, then months of launch-pad testing in Virginia before a date is set.

A few pockets of trapped air, buried between layers of carbon fiber, have pushed one of the most anticipated new rockets in America into 2027. Rocket Lab confirmed that Neutron, its reusable medium-lift launcher, will not fly this year because of a defect found in the domes that cap its first-stage fuel tanks.

Why should anyone outside the space business care? Neutron is meant to be a second option for the satellites behind home internet, Earth imaging and national security, at a moment when demand for rides to orbit keeps climbing. Every month it stays on the ground is a month customers wait, and a month the market leans even harder on SpaceX. So what exactly went wrong inside those tanks, and is it really fixed? The answer says a lot about how hard big carbon fiber rockets are to build.

01

What caused the Neutron rocket delay

The Neutron rocket delay comes down to voids, which are small air gaps between the layers of carbon fiber that make up a tank dome. Rocket Lab founder and CEO Peter Beck explained in a company video that the team spotted a problem with how the propellant domes were being made, stopped production and dug into it.

The domes sit at each end of the booster’s methane and liquid oxygen tanks. Those tanks are the biggest parts of the rocket, and they have to hold high internal pressure through launch and the trip back down. Inspectors found the gaps in a freshly cured forward dome. Beck said the voids don’t automatically mean a dome would fail in flight, but that the company only moves ahead when it believes there is enough safety margin.

In other words, this was a quality call, not a breakage. The part was judged not good enough, so it was scrapped and rebuilt.

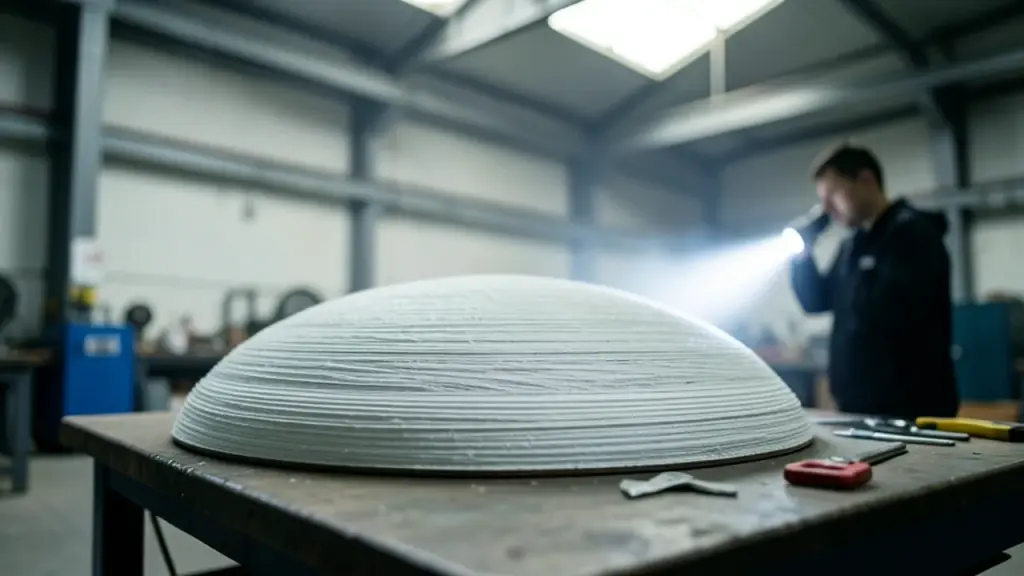

Factory view of carbon tank dome under flashlight inspection
02

Why carbon fiber is so hard to get right at this size

Carbon composite is the reason Neutron’s booster can be light, strong and resistant to corrosion, and it is also the reason it is hard to make. Workers or machines lay sheets of carbon fiber into a mold, then heat, or cure, the stack so the fibers bond into one solid piece. If air gets trapped during that process, it stays trapped.

Most aerospace factories cure big parts in an autoclave, a pressurized oven that squeezes out air as it heats. Neutron’s parts are too large for that. Beck has called the first stage the largest pressurized structure ever built from carbon composite, so Rocket Lab had to invent out-of-autoclave methods, including custom heating cycles for the giant forward and aft domes.

For a sense of scale, Rocket Lab’s smaller Electron rocket is also carbon fiber, but Neutron is many times wider. Processes that work on a slim rocket don’t automatically work on one that big.

Play video: Rocket Lab | Neutron Update
03

A fix for one problem created the next one

The voids were not random bad luck. Engineers traced them to a design change meant to make the tank stronger. Earlier this year, a Neutron propellant tank burst unexpectedly during a pressure test using water. Rocket Lab blamed a manufacturing flaw at a key joint in that tank, which had been built by an outside contractor laying the carbon by hand while Rocket Lab waited for its own automated fiber placement machine to come online. That machine now works.

After the rupture, the company removed joints from the first-stage tank design and made some sections of carbon thicker. Those thicker sections are exactly where the new air pockets showed up. Rocket Lab then adjusted its manufacturing process again, and an aft dome made the new way passed inspection. Beck said the problem is solved and the forward dome has since been replaced, but the time spent investigating and rebuilding is what pushed the first launch into next year.

Small satellite team around a scale rocket model in workshop, hands discuss schedule
04

What still has to happen before Neutron launches

A clean dome is only one item on a long list. The first stage still needs final qualification, and so does Archimedes, the methane-burning engine that powers the booster, nine at a time. The upper stage and the payload fairing finished qualification testing earlier.

After that comes the launch campaign at Wallops Island, Virginia. For a brand-new rocket, that usually means months of fueling tests, countdown rehearsals and a static fire, where the engines run while the rocket is held down. Problems often surface during this phase, which is the whole point of doing it. Rocket Lab has not given a launch date, saying the Stage 1 tank must clear testing first, and its target is no earlier than 2027.

Neutron also has an unusual design. The upper stage and the satellite ride inside the booster’s nose, which opens like a clamshell a few minutes after liftoff to release them. The booster then closes up and flies back to land on a platform at sea so it can be reused.

05

What the delay means for satellites, prices and your internet

For everyday people, the impact is indirect but real. Many satellite startups, including those planning internet and imaging services, rely on affordable rides to orbit. SpaceX dominates that market, and it plans to shift toward its giant Starship and eventually retire its Falcon 9 from commercial service. That leaves room for a mid-sized reusable rocket, and other companies including Firefly Aerospace, Stoke Space and Relativity Space are chasing the same customers.

Customers do not seem scared off. In its third-quarter report on November 9, Rocket Lab said it had 16 Neutron missions booked before a single flight, after signing more than $515 million in Neutron contracts with constellation operators. It also raised Neutron’s base price from $55 million to $70 million, pointing to strong demand.

Washington is backing it too. The same day, a Pentagon lending arm, the Office of Strategic Capital, put $150 million on the table as a conditional loan, aimed at helping Neutron fly more often once it debuts, through more recovery ships, more engine and composite production and faster turnaround between launches. The loan is not final; Rocket Lab still has to meet financial, legal and technical conditions before it closes.

Rocket Lab’s business is growing regardless. Quarterly revenue hit a record $267.8 million, up 73% from a year earlier, though the company still posted a loss. Its finance chief expects adjusted earnings to go positive in the half year after Neutron first flies successfully, which shows how much now rides on those domes.

06

Quick answers

When will Neutron launch?

Rocket Lab now targets no earlier than 2027 and has not named a specific date. It wants the Stage 1 tank to pass testing before setting one.

Was the rocket damaged or did it fail?

No. Inspectors found air pockets in a newly made tank dome before it was used. The part was replaced, and a dome built with the revised process passed inspection.

Is Rocket Lab’s Electron rocket affected?

No. Electron keeps flying from New Zealand, and its hundredth mission was scheduled for no earlier than November 14, 2026.
